BKV's Self-Regulated Operations- Near Old Justin Rd.


BKV plans to perform drilling and completion operations on three wells located at 1303 Old Justin Road. During this time, and always, safety is our top priority. Employees and contractors are held to a high standard and are required to comply with all safety rules and regulations. BKV will be imposing self-regulated work hours (drilling and flowback operations are exempt) and are committed to partnering with the neighbors to ensure everyone's safety.

We will update this site with information regarding BKV's operations.


Carl McCurley Project Timeline

All timelines are approximate and given as a reference only. Dates can shift due to changes in operational and environmental factors.
We will continue to update this site accordingly.



February 5th- February 10th

(6 am-10 pm)

Workover Rig


February 11th- March 7th

(6 am-10 pm)

Pad Construction/Expansion


March 10th- March 14th

(6 am- 10 pm)

Sound Wall Installation


March 20th-March 25th

(6 am-10 pm)

Drilling Rig Move-In


March 26th- April 15th

(24-hour operations)
Drilling Operations


April 21st- May 21st

(6 am-10 pm)

Completion Operations


May 24th-May 31st

(24-hour operations)

Flowback Operations

Project Details

Here are specific details regarding BKV’s drilling and completion operations at the Carl McCurley pad location near Old Justin Rd.

  • BKV’s increased activity is temporary.
  • Installation of temporary sound barriers around the wellsite will reduce the sound coming from the location. These barriers will be removed upon completion of this project.

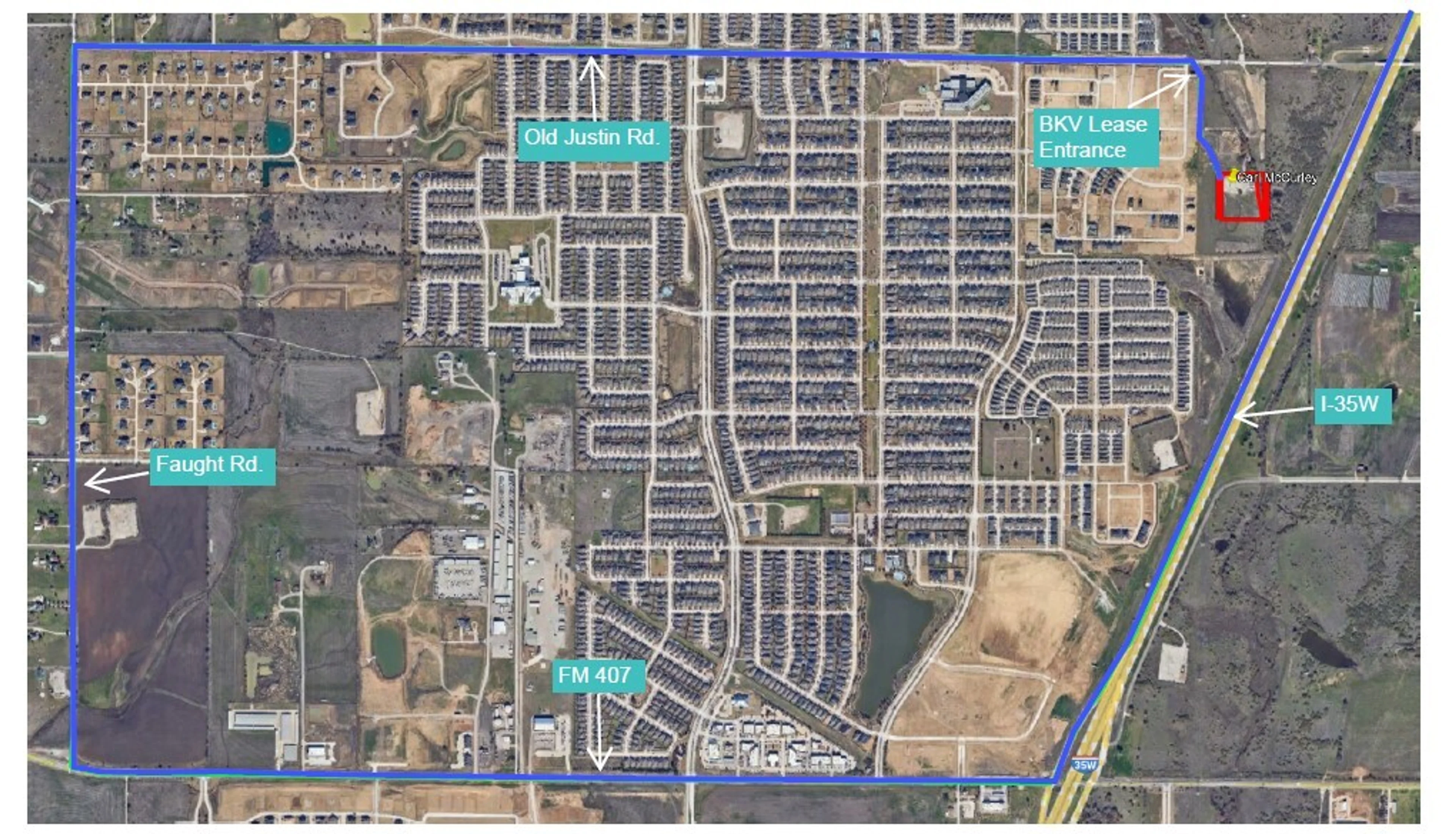

  • All trucks will be routed along the access route shown on the map (to the left) and will enter and depart this location from an existing BKV lease road.
  • At the conclusion of the project, normal day-to-day operations will resume.
